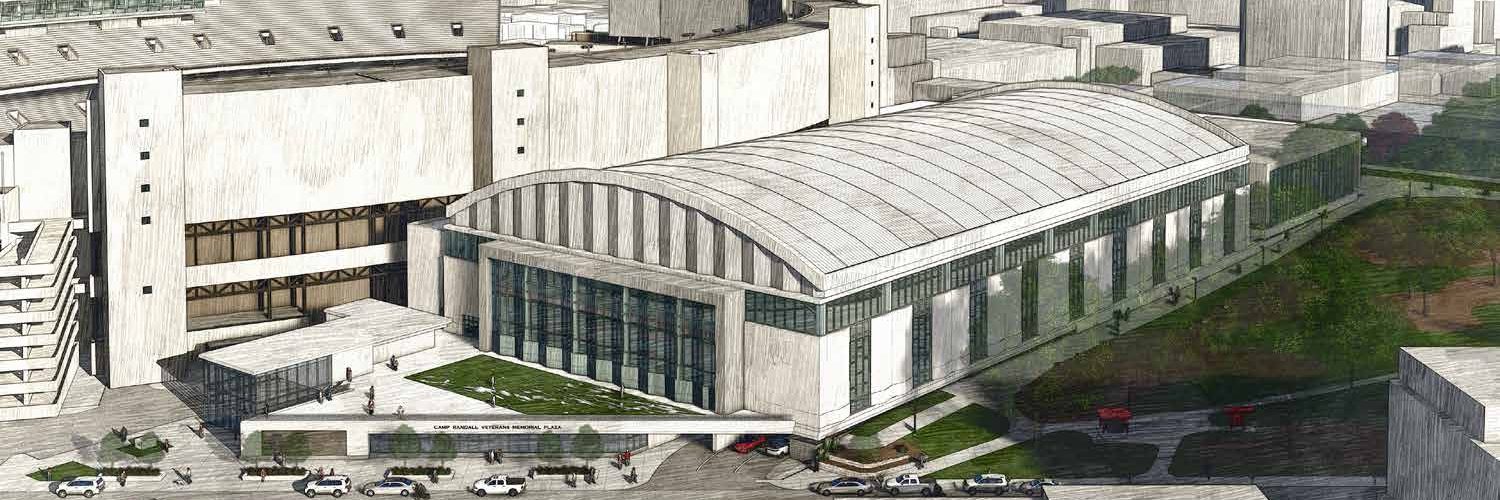

This project constructs a three-story addition to house the Center for Dairy Research (CDR), a milk intake facility with three storage silos, and a small addition to house a two-story dryer. Space on the basement, first, and second levels of the existing dairy plant will be renovated. The existing milk intake area, the existing drying tower, a mechanical space at the northwest corner of Babcock Hall, and a stair tower will be demolished to make room for the addition.
This is an accordion element with a series of buttons that open and close related content panels.
Budget
| Total Soft Costs | $5,356,400 |
| Total Construction Costs | $41,563,600 |
| Total Project Costs | $46,920,000 |
| Funding Sources: | |
| GFSB | $22,209,000 |
| Gift/Grant | $18,461,000 |
| Cash | $6,250,000 |
Timeline
| A/E Selection | 11/2013 |
| Design Report | 02/2017 |
| Bid Date | 03/2018 |
| Start Construction | 05/2018 |
| Substantial Completion | 11/2020 |
Key Stakeholders
| Occupants | Babcock Dairy Plant/CDR |
| User Reps | Doug Sabatke |
| UW PM | Steve Richards |
| DFDM PM | Kevin Trinastic |
| A/E | Zimmerman Arch. Studios |
| Design Arch. | Zimmerman Arch. Studios |
| Landscape Arch. | Zimmerman Arch. Studios |
| Structural Engr. | Harwood Engineering |
| General Contractor | CD Smith |
| Plumbing | Hooper Corp. |
| Mechanical | NAMI, Inc. |
| Fire Protection | J.F. Ahern Co. |
| Electrical | Morse Electric, Inc. |
Area Data
| GSF-Babcock Remodel | 29,700 |
| ASF-Babcock Remodel | 23,575 |
| Efficiency-Babcock Remodel | 79.38% |
| GSF-CDR Addition | 54,650 |
| ASF-CDR Addition | 33,145 |
| Efficiency-CDR Addition | 60.65% |
| Construction $/GSF | $493 |
| Construction $/GSF | $733 |
| Total Project $/GSF | $827 |
